    North Beach Utilities Underground Conversion

Project Description

The Design and Construction Management (DCM) and Public Utilities (PU) Departments have executed a Construction Manager at Risk (CMAR) contract with Whiting-Turner (Construction Manager) on the Hollywood North Beach Utilities Underground Conversion project.  Whiting-Turner along with their Consultants/Subcontractors have begun construction activities. Construction updates can be found below.

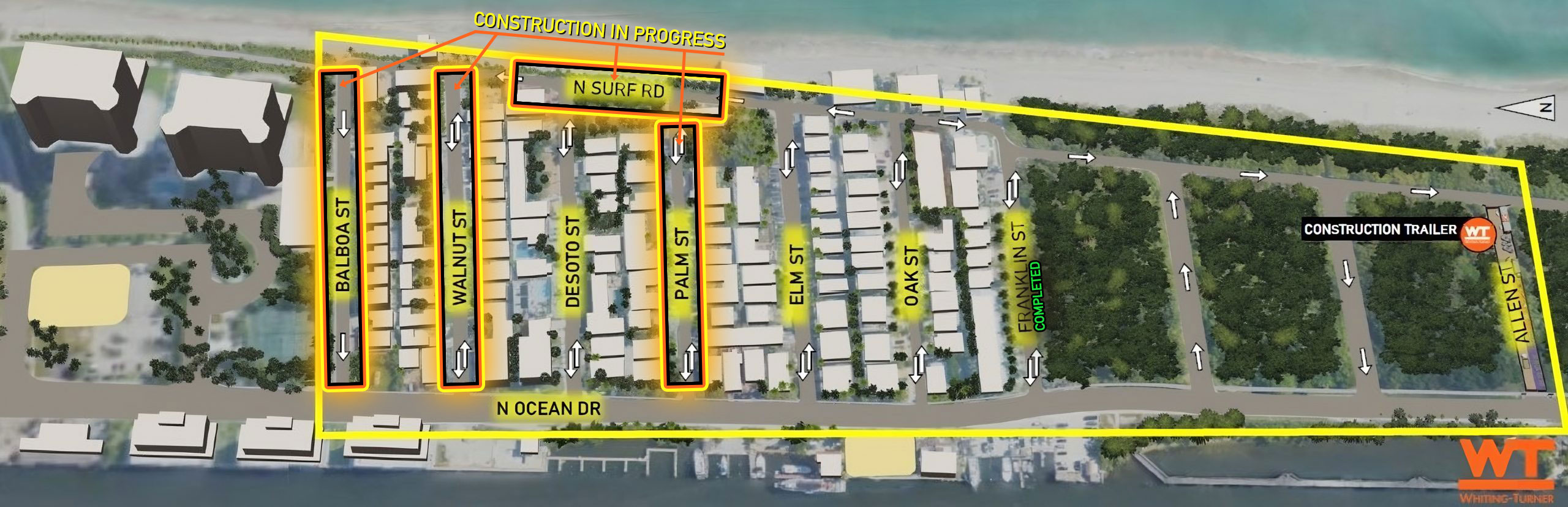

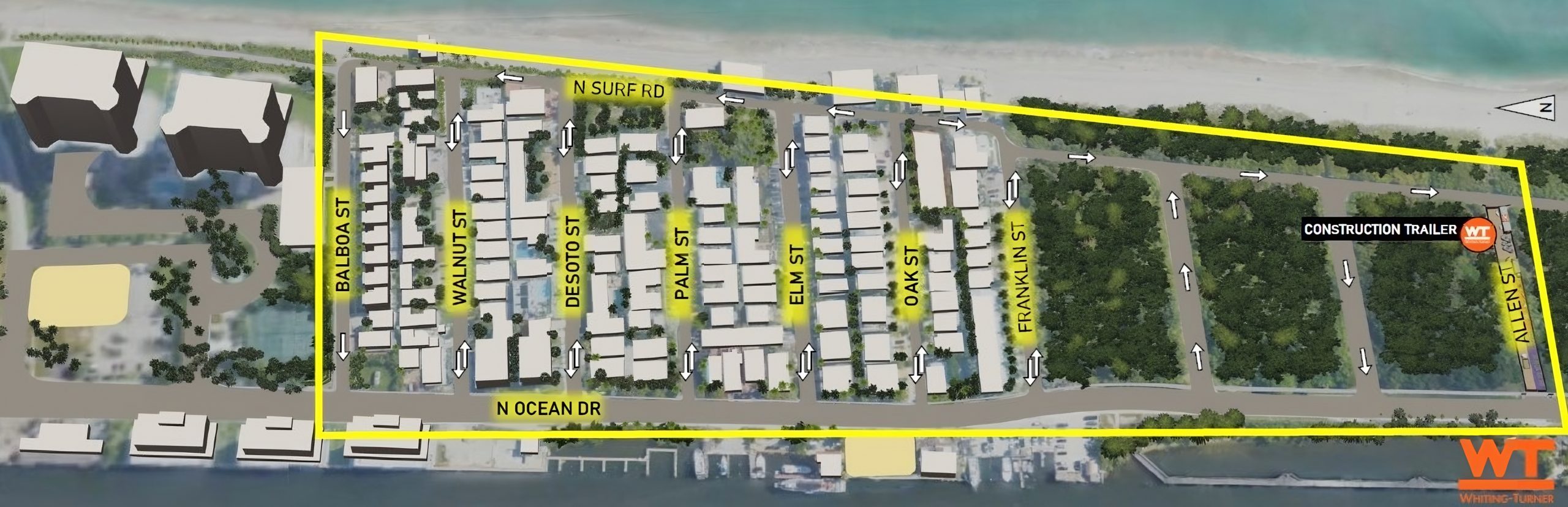

Work has commenced and will continue from Franklin Street to Balboa Street between A1A and Surf Rd. (Residential Area). Work between Douglas and Freedom St. (Condo Area) is almost completed. See below for current construction updates.


Construction Updates (Through September 2025)

  • Watermain Installation on Franklin- 100% Complete
  • Watermain on Surf Rd. - 100% Complete
  • Watermain on Oak St. - 100% Complete
  • Watermain on Balboa St. - 100% Complete
  • Watermain on Palm St. - 100% Complete
  • Watermain on Desoto Street - 100%
  • Walnut Street - 100%

Overall Watermain Installation - 100%

  • Electrical Conduit Installations (Overall) - 100%
    • Conduit (Mainline) - 100%
    • Conduit (Private Services) - 100%
    • Conduit (Street Lighting) - 100%
  • Electrical Transformer Installation (Overall) -100% Complete
    • Transformer Pad Installation - 100% Complete
  • Electrical Conductor "Primary" (Cable) Installation - 98% Complete
  • Electrical Street Lights - Pendingo Electrical Conversions (Residential) -Pending
  • Private Side Conversion (Residential) (ATT, Comcast) - Pending
  • Electrical Conversion (Condo Area) - 90% Complete
  • Wreck-out of Existing Overhead - Pending (by others)
  • Asphalt Paving (All Areas) - Pending

The duration of the project will be approximately 30 months with completion scheduled for Fall 2026.

During construction, access to driveways may be limited in
the work zone. Notices for construction will be provided at
least 1 week prior to the commencement of work on each
subsequent street.

Temporary Parking will be available for residents directly
affected by construction activities. Registration for parking
passes is available by completing the Temporary Parking
Registration Form below under "Project Documents".
Parking Decals will be distributed to each resident.

In Partnership With

Hollywood on the Go!
Whiting-Turner
The Merchant Strategy

Important Dates

Public Meetings

TBD




Neighborhood Meetings

TBD

Hollywood North Beach Utilities Underground Conversion Groundbreaking Ceremony

Monday, May 6th @ 10AM

A1A and Balboa Street

Frequently Asked Questions

Contact Us

If you would like more information about this project, please use the form below to get in touch.  You may contact the Public Involvement Manager using the information below:

Hollywood North Beach Project Hotline
561-382-2766
